Schedule Run - From Initialization to Completion

Updated by Kashif Hussain

This guide will help you navigate how a scheduled run executes from inception to completion.4

The schedule run process operates across three hierarchical levels. Below is a comprehensive guide to each status at every level.

How to Visualize the Run

Go to Automation from the left navigation panel

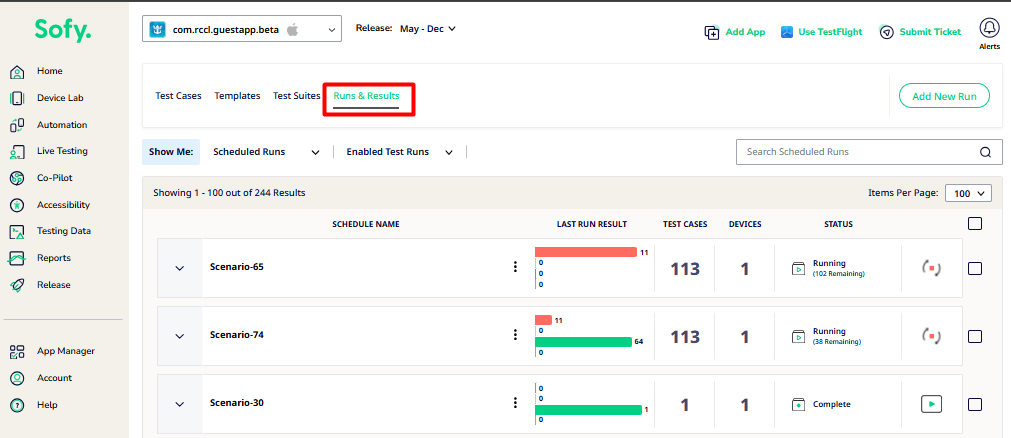

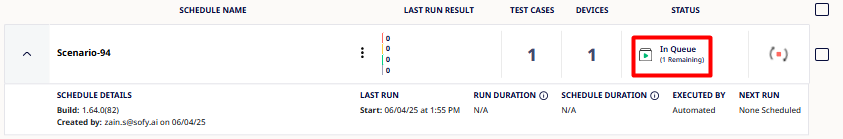

Select the Runs & Results tab to view the list of all schedule runs.

This represents the overall status of the entire test schedule.

Status

Description

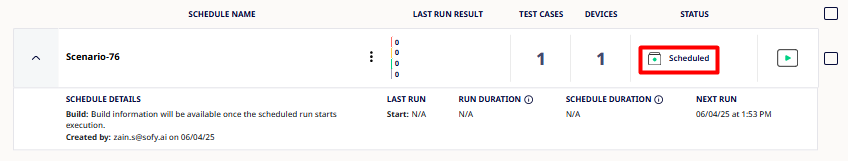

Scheduled

The schedule is created and will be triggered at a future time.

In Queue

The schedule has reached the device farm and is waiting for device allocation.

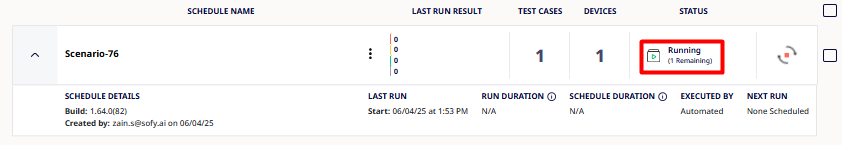

Running

Schedule execution has started and includes the following steps: device setup, app installation, test case execution, retries, and result upload.

Finalizing

Schedule execution has completed, and final operations like report generation or log uploads are in progress.

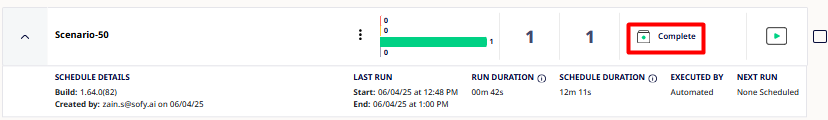

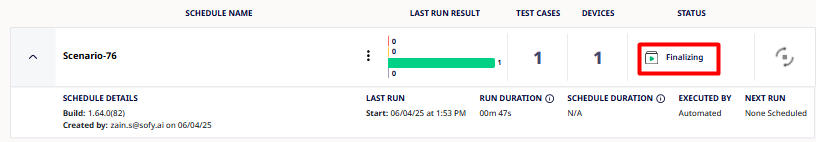

Complete

Schedule completed successfully. All test cases either passed or passed with warnings.

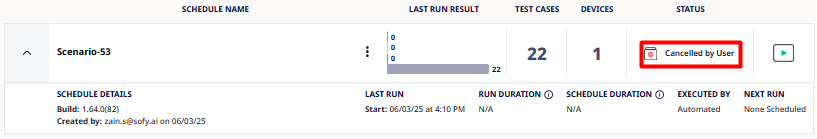

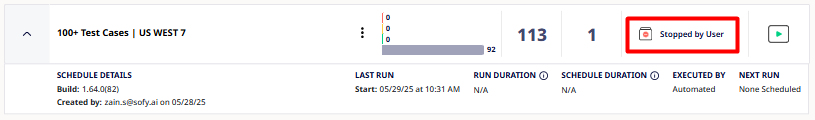

Stopped by User

Execution was manually stopped by the user during the run.

Cancelled by User

Execution was manually cancelled by the user while still in the queue.

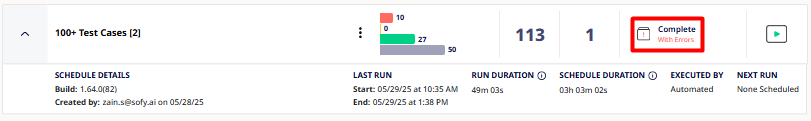

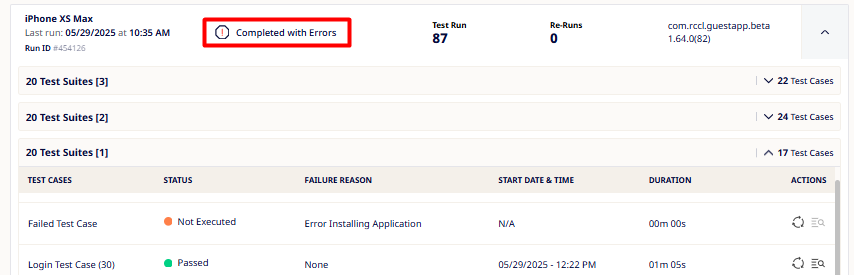

Complete with Errors

Schedule completed but contains failed, incomplete, or not executed test cases.

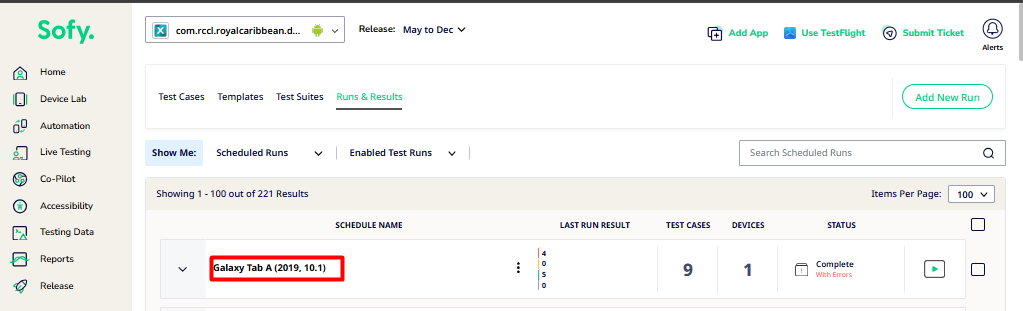

Click on a Schedule Name from the list to view details of its test runs.

Execution statuses of an individual test run within the schedule.

Status

Description

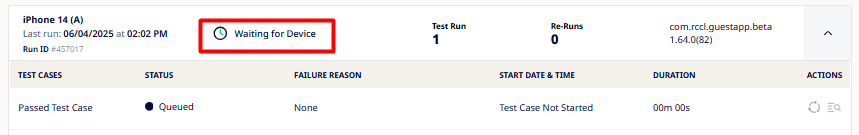

Waiting for Device

The test run is queued and waiting for device allocation.

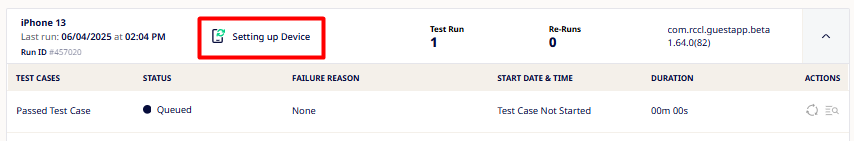

Setting up Device

Device controller and environment setup in progress.

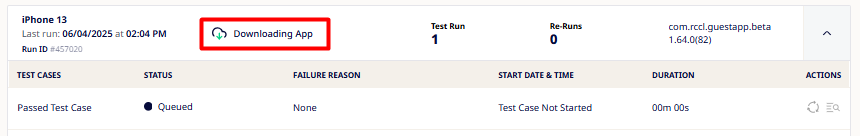

Downloading App

Application binary is being downloaded onto the test device.

Parsing App

The application is being loaded and analyzed before installation.

Loading Scenarios

Test Cases are being loaded and prepared for execution.

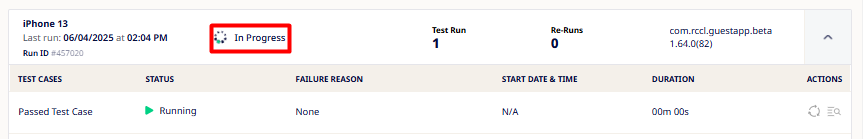

In Progress

Test case execution is underway.

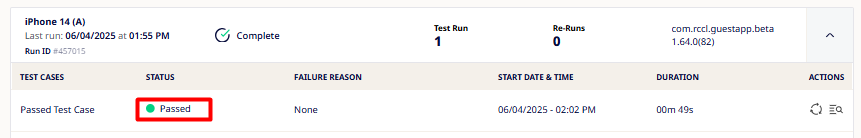

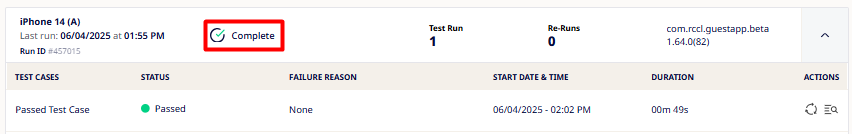

Complete

Test run completed successfully with all test cases either passed, failed or passed with warnings.

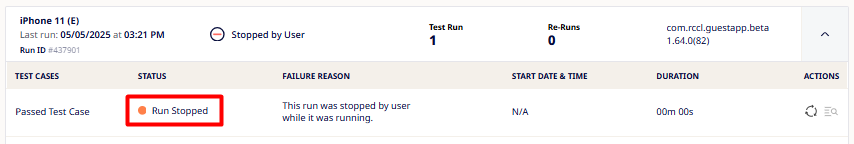

Stopped by User

Execution was manually stopped by the user during the run

Not Executed

Test run not executed due to issues like: Concurrent session limits, App installation failure, Device/Appium server disconnection, Internal errors or Timeouts

Complete with Errors

Test run executed but includes failed, incomplete, or not executed test cases.

Granular status and results of individual test cases within a test run.

Status

Description

Queued

The test case is waiting for device execution.

Running

Test case execution in progress.

Passed

Test case executed and passed successfully.

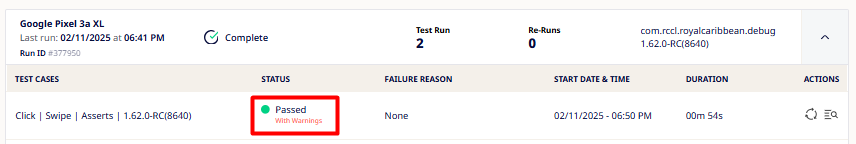

Passed with Warnings

The test case passed but encountered one or more non-critical warnings during execution.

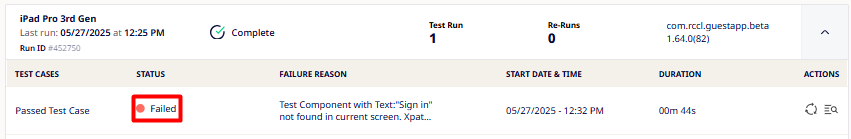

Failed

The test case failed during execution.

Incomplete

The test case was interrupted due to a timeout or unexpected issue.

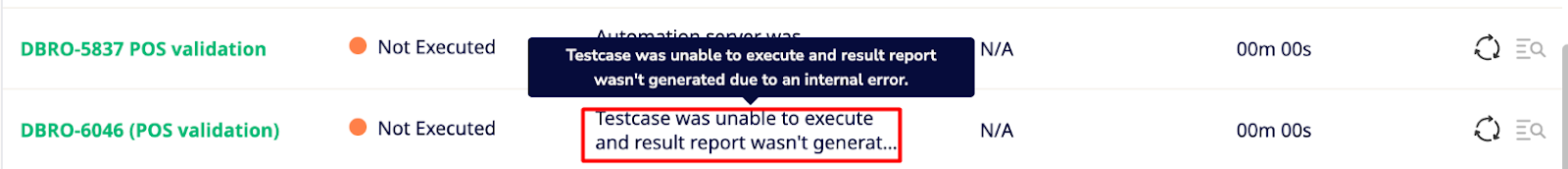

Not Executed

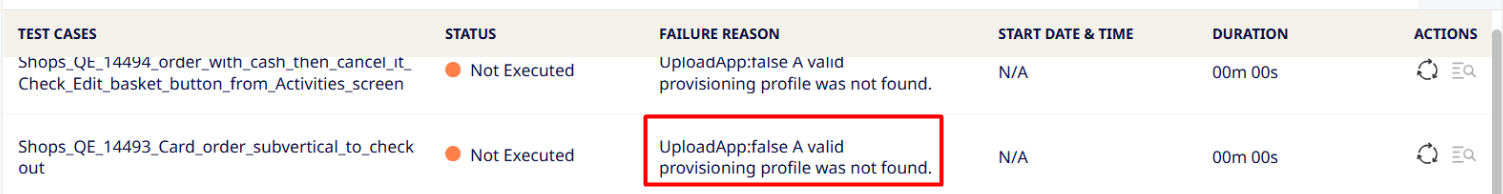

Test case not executed due to: Session limits, App installation issues, Device/Appium server disconnection or Internal error.

Run Stopped

Execution was manually stopped by the user while this test case was running.

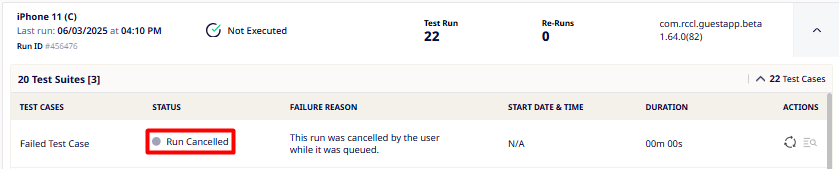

Run Cancelled

Execution was cancelled before this test case started.

Failure Reasons - Descriptions

These are the common failure reasons encountered during schedule or test execution. Each reason may indicate an infrastructure, configuration, or environment-level issue.

Failure Reason

Description

Application Launch Failure

The app was installed but failed to launch on the test device.

Failed to Parse App

The system was unable to analyze the app before installation. This can occur due to corrupt APK/IPA files, provisioning issues or Invalid certificates.

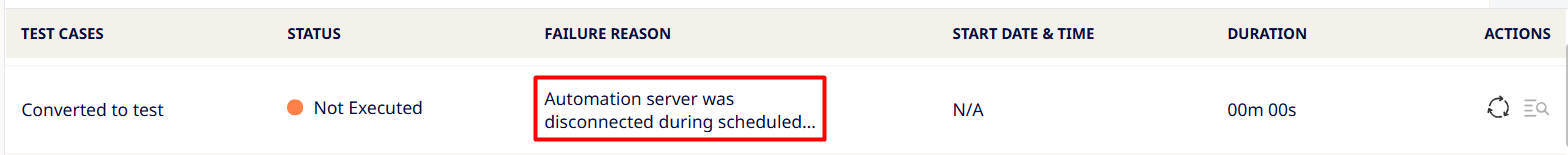

Automation Server Disconnection

The automation framework (e.g., Appium) lost connection during test execution. This may be caused by network issues or server crashes.

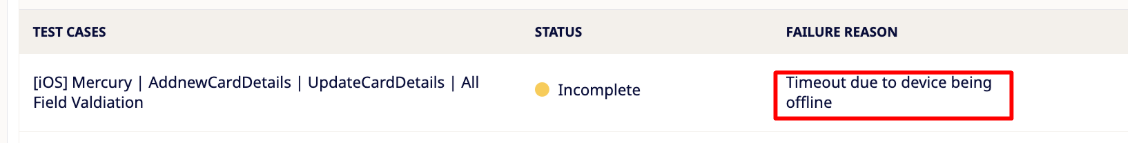

Timeout – Device Offline

The assigned device went offline unexpectedly. After waiting for up to 2 hours for it to come back online, the run timed out with a "Timeout – Device Offline" error.

Internal Error

An unexpected system-level issue occurred during execution. Logs should be reviewed for more details.

Failed Device Communication Error

The platform was unable to communicate with the device, possibly due to network disruption, service crashes or device health issues.

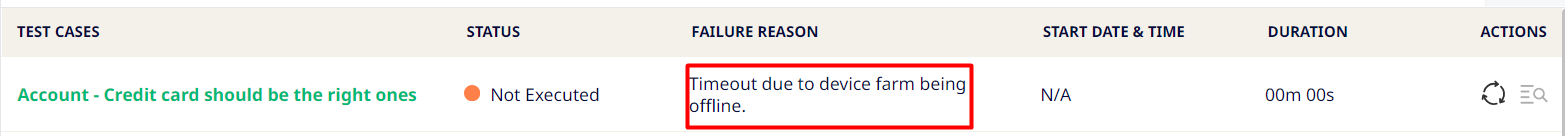

Timeout – Device Farm Down

The device farm infrastructure was temporarily unavailable or unresponsive, causing the test to timeout.

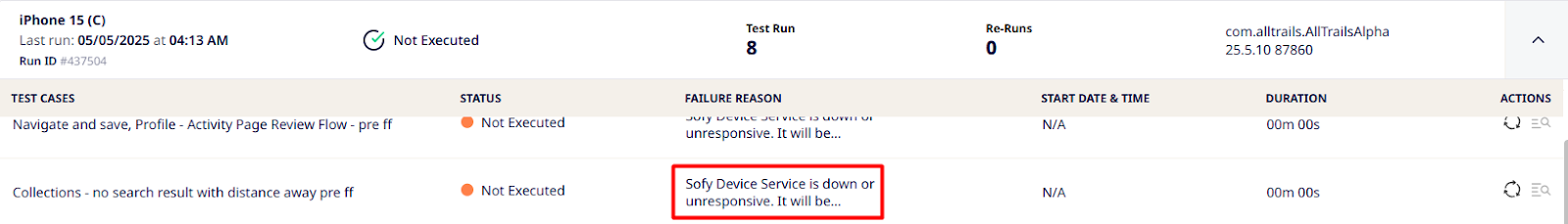

Sofy Device Service Interruption

A temporary Sofy service interruption caused by a brief network disruption.

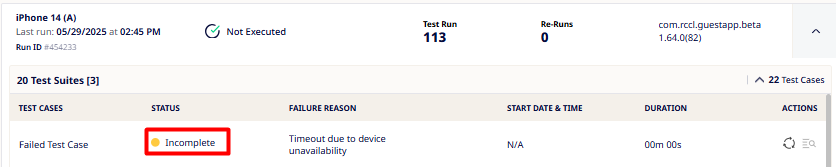

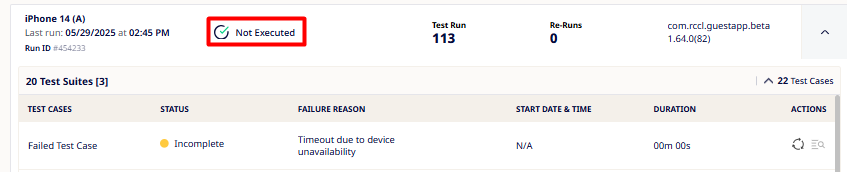

Timeout – Device Unavailability

The assigned device was already in use by another session or schedule. After waiting for up to 2 hours for the device to become available, the run timed out with a "Timeout – Device Unavailability" error.
